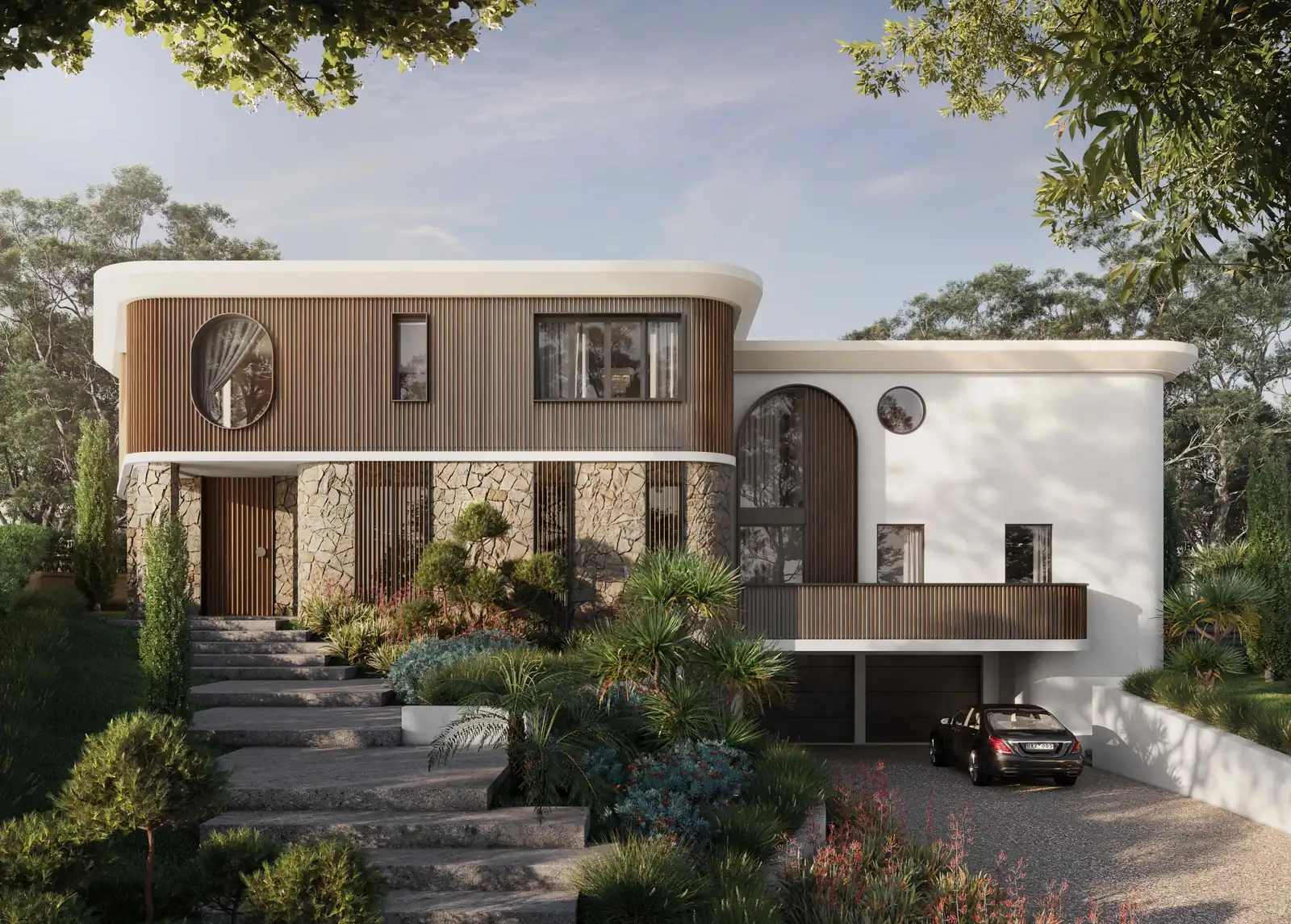

The Symphony in Sydney: a curved white roof over timber-clad and split-stone walls, with stone steps up through the front garden

Knockdown Rebuilds and New Homes in Sydney

Sometimes the house on your block can't become the home you need, and starting again is the better decision. We're knock down rebuild architects in Sydney, designing new homes for families who plan to stay, and we manage the CDC or DA.

A knockdown rebuild may be the better option when the existing house no longer works for your needs, whether it's due to a poor layout, structural issues or the extent of renovations required. Renovating may make more sense when the house has good structural foundations, is located in a heritage conservation area or when the budget doesn't allow for a complete rebuild. We assess both options against your property's planning controls and your budget, helping you make an informed decision before committing to the design process.

When starting again is the better decision

Meridian in Leichhardt: a red-brick federation home with a white rendered second storey above, beside a jacaranda in bloom

Renovating keeps the frame and the roof, which only saves money if they're worth keeping. Homeowners on renovation forums often describe old houses that hid problems, such as rotten framing, and turned a modest job into a big one. When most of the house would be opened up anyway, a new home is often simpler to design, price and build.

We design both, so we have no reason to push you either way. At Meridian in Leichhardt, the feasibility showed that extending beat a knockdown, so most of the federation house was kept. The guide Knock down and rebuild, or renovate? lists the questions to answer first.

Renovate or rebuild: how the two compare

Renovate and extendKnock down and rebuild
ApprovalA CDC if the land and design meet the Housing Code, otherwise a DAThe same test for the new house
Heritage conservation areaUsually a DA. Some internal and ground-floor work can be a CDCA DA, including the demolition
SurprisesHidden problems once walls are openedFewer inside; demolition and site costs come first

What Makes an Architect-Designed Home Different?

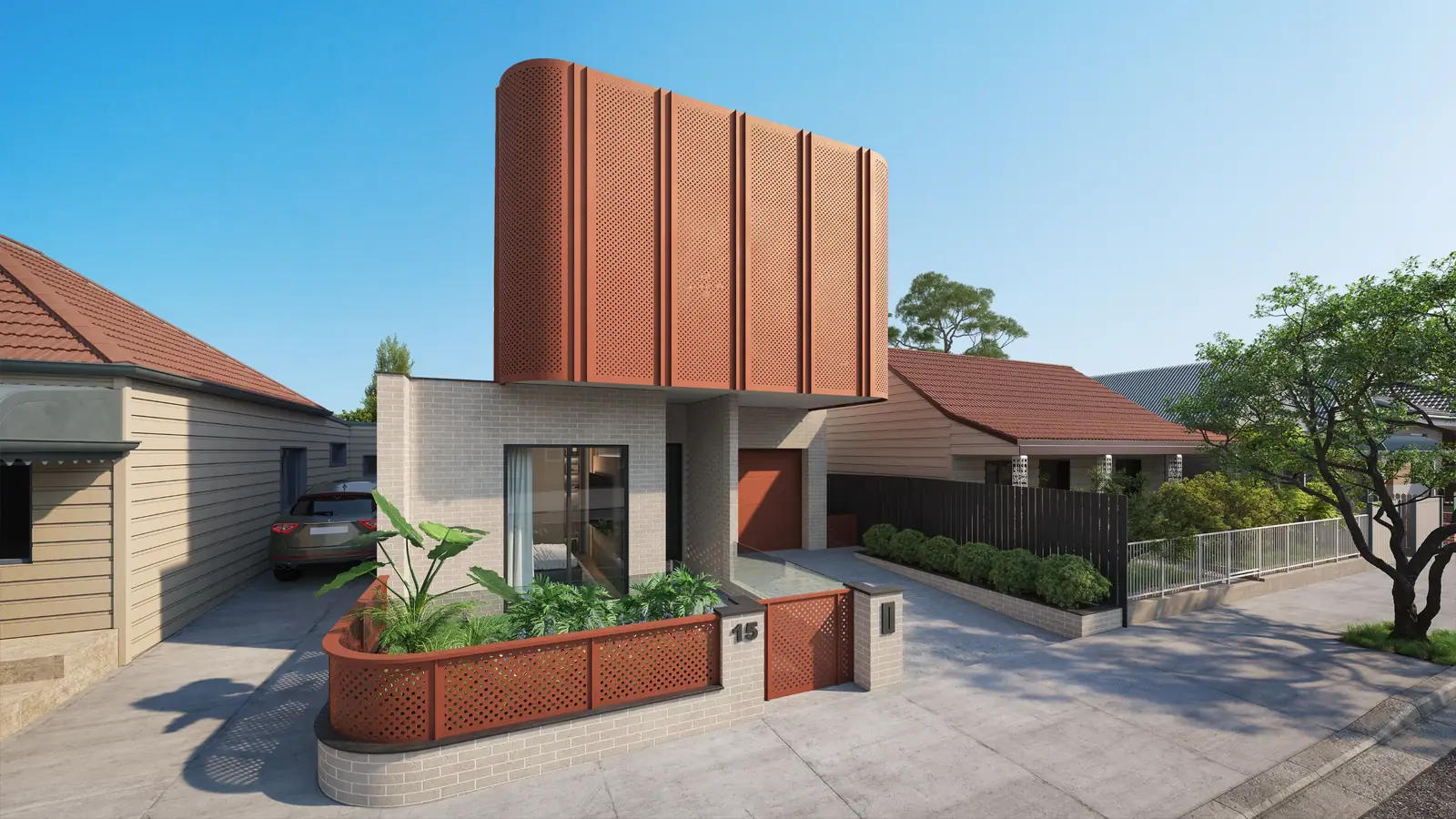

Aurum in Lilyfield: a new family home with a curved, perforated terracotta upper floor over a pale brick base, in a street of older houses

Project homes suit a flat, regular block and a standard brief. If that's yours, a volume builder may be the simpler route, and we'll say so on the call.

An architect-designed home starts from your block: a slope, a narrow lot, north light falling on the back fence.

You own independent drawings

Our drawings and specification describe the whole house, so several builders can price exactly the same thing.

You see the whole cost early

Homeowners on Australian forums often report project-home prices growing once site costs, upgrades and landscaping were added. Our fees are fixed per stage and agreed in writing, and we test the design against your budget as it develops.

Homes for more than one generation

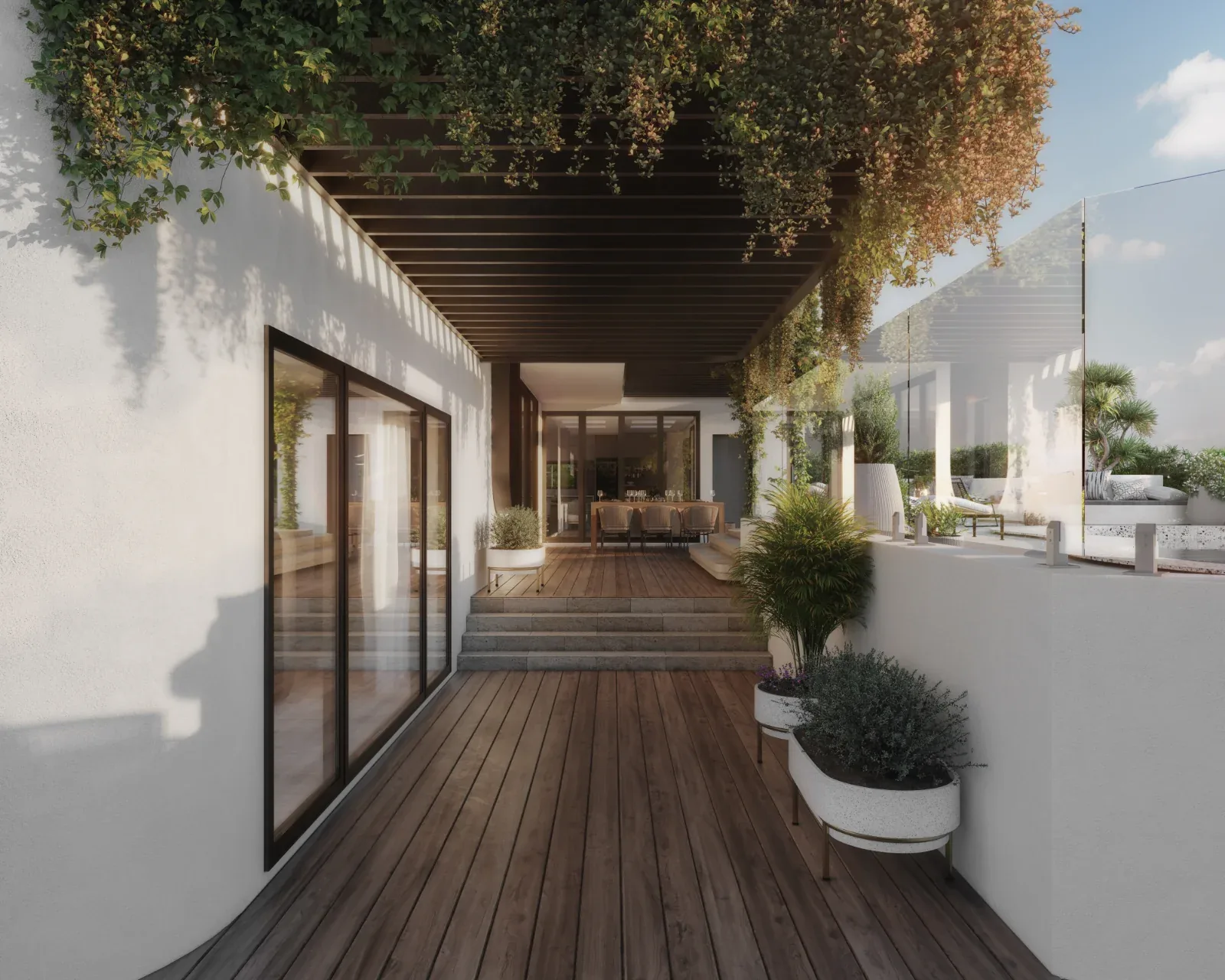

A covered timber deck under hanging greenery, opening onto the terrace and garden, The Symphony, Sydney

A home for grandparents, parents and children works when everyone has somewhere to retreat to, and when the house can change as the family does.

The Symphony, completed in 2023, is our clearest example. The site was bought to knock down and rebuild as one home for several generations. On a 963 m² block we designed 480 m² of internal space: six bedrooms, eight bathrooms and three living areas. We plan homes like this around a bedroom and bathroom on the ground floor, living areas far enough apart for two quiet evenings, and rooms that can change use.

Two more of our new homes are under construction: Aurum in Lilyfield, a knockdown-rebuild, and Solace in Wareemba, a three-level family home.

"OIC considered what I'm going to do and how my family's going to use the space, not just the house itself. They asked things I hadn't even thought about, like whether I would have more kids, and they planned for it either way."
Cheryl, The Symphony
Watch the full interview

CDC or DA for a new house

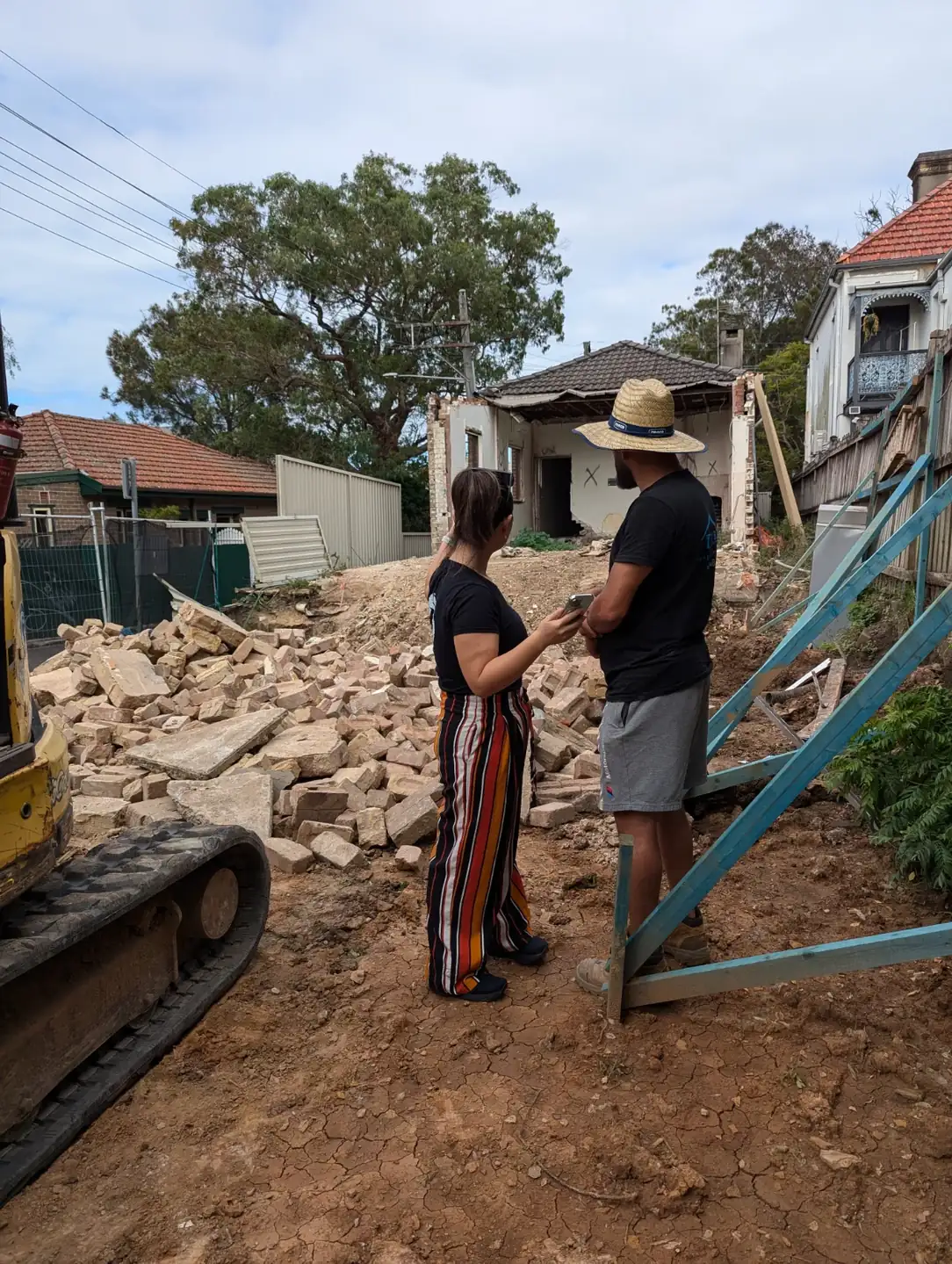

An OIC architect and a builder talking beside the rubble of a part-demolished house

A new one or two-storey home may qualify for a CDC, issued by council or a registered certifier, provided the property and design meet the NSW Housing Code requirements. The key eligibility criteria under the Codes SEPP include:

  • zoned R1, R2, R3, R4 or RU5, at least 200 m² and 6 m wide at the building line
  • not a heritage item, and not in a heritage conservation area
  • outside the 25 ANEF aircraft noise contour and higher ones
  • not in bush fire attack level BAL-40 or the flame zone, and on a flood control lot, only on parts certified clear of floodways and high-hazard areas

A basement counts as a storey, so two floors over a basement garage is three storeys and needs a DA. If any test fails, the house goes to council as a development application (DA), assessed on merit and usually slower (see DA and CDC approvals).

Demolition

Demolishing a house can also be complying development, except in a heritage conservation area, where it needs a DA and council will weigh what the house adds to the street. SafeWork NSW warns that homes built or renovated before the late 1980s may contain asbestos, and removing more than 10 m² of non-friable asbestos needs a licensed removalist. If a neighbour's wall is within 900 mm of the boundary, a CDC demolition also needs an engineer's report.

Costs beyond the build

The builder's price isn't the only cost. We put figures against these for your block at feasibility.

CostWhat it isWho sets it
Design and consultantsOur fee per stage, plus survey, engineers and reportsOIC and consultants
BASIX certificateRequired for every new home, lodged with the DA or CDCNSW Government
Long service levy0.25% of works costing $250,000 or more (incl. GST)Long Service Corporation
ContributionsA section 7.11 or 7.12 charge (up to 1% of cost in most areas), if your council's plan applies oneYour council
Water and sewerApproval of the building plans, and connectionsSydney Water
Demolition and site worksAsbestos, disconnections, excavation, driveway, landscapingBuilder or contractors
Builder's insuranceRequired for contracts over $20,000. See the certificate before paying any deposit (10% maximum)Your builder
Rent and movingSomewhere to live for the whole buildYou

How a new home project runs

A fixed fee for each stage, agreed in writing before it starts.

  1. Free 15-minute call

    By phone or video: whether we're the right fit, and what the next step is. Not a design session.

    Free
  2. Feasibility study

    Renovate or rebuild, CDC or DA, and what the budget buys on your block. A written answer you keep.

    Credited if you go ahead
  3. Design

    Concept options, then the design resolved with engineers and BASIX, tested against your budget

    usually 4-6 weeks
  4. DA or CDC

    We prepare the application and manage it to a decision.

    Council or certifier
  5. Drawings and building

    Construction drawings so several builders price the same house. Site inspections and builder oversight if you want them.

    Oversight optional

Questions people ask about knockdown-rebuilds

Is it cheaper to knock down and rebuild than to renovate?

Sometimes, but not as a rule. Renovation work is often priced higher per square metre than new building, because the builder works around, and repairs, what's already there. A rebuild adds demolition, site costs and rent for the whole build. It depends on the house, the rules and how much you'd change anyway. Our feasibility study compares both for your block.

Can we knock down a house in a heritage conservation area?

Not with a CDC. Demolishing the house needs a development application, and council will weigh what the house adds to the street. If the house is a listed heritage item, complying development isn't available at all.

How long does a knockdown-rebuild take?

Design and approval come first. A CDC can be issued in as little as 20 days, plus 14 days of neighbour notice (NSW Planning). DA times vary by council: in the September 2026 snapshot, Inner West Council averaged 96 assessment days and the City of Sydney 53. Ask each builder for a construction period in their tender. Design takes about 4-6 weeks together with the required reports from other consultants.

Can we include a self-contained flat for parents?

Yes, but it's a separate approval. A Housing Code CDC allows one dwelling house on the lot, and a self-contained flat is a secondary dwelling (a granny flat). As complying development, that needs a lot of at least 450 m², unless the flat sits entirely within the house; otherwise it goes to council as a DA. Some families prefer one shared home with private zones, as at The Symphony.

Do you build the house as well?

No. We design the home, manage the approval and coordinate your builder. Because we're independent of the builder, several builders can price the same drawings, and someone is on your side when questions come up on site. Site inspections and builder oversight are there if you want them.

Tell us what you are planning. In a free 15-minute call we will tell you honestly whether we are the right fit, what the approval route looks like and what the sensible next step is.

An OIC architect going over plans with three builders on a construction site
